Answers

Navigating Custom Furniture Timelines: Setting Client Expectations Early

Published May 7, 2026

Navigating Custom Furniture Timelines: Setting Client Expectations Early

If you specify custom furniture, you know how managing client expectations around timelines can quietly drain your project's momentum. A client sees a 16-week lead time on a proposal and sets their mental clock. But that clock doesn't start ticking the day they sign. The real timeline is a chain of dependencies—and a delay in any single link can throw off an entire install.

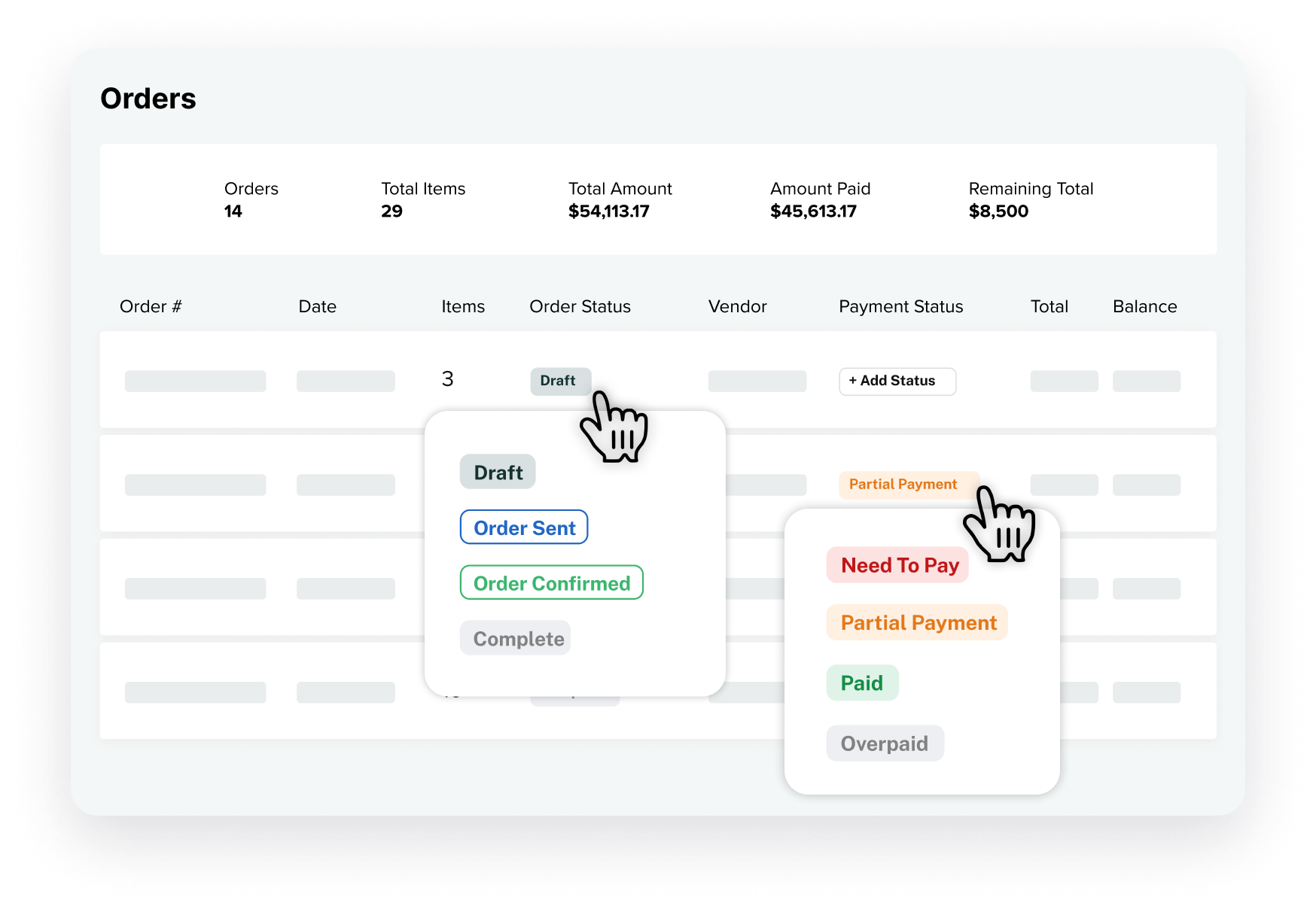

Alcove at a glanceSee freight, receipts, and delivery milestones in context.

Most studios I know track these moving parts across a mix of spreadsheets, vendor emails, and maybe a project tracker. You have a cell for the quoted lead time, another for the COM delivery date, and a separate email thread for the shop drawing approval. It works—but it puts the burden on you to connect all the dots for your team and your client.

The reality of custom—why timelines aren't linear

Alcove at a glancePlace and track vendor orders without spreadsheet chaos.

Ordering a custom piece isn't like pulling a lamp from a retailer's inventory. It's commissioning a unique work. It doesn't exist yet. It has to be designed, engineered, and built by hand. That process is just less predictable than an automated, off-the-shelf supply chain.

I think of it as a relay race. The baton passes from design approval to deposit, from material sourcing to fabrication, from freight to final inspection. Each handoff is a potential point of delay. A fabric mill in Europe might have a backlog. A specific wood veneer could be out of stock. A shipping container might get held up in customs.

Your best tool here is transparency. Explaining the why behind the timeline from the start helps clients see their custom piece differently. It's not a product they are buying—it's a project they are commissioning alongside you.

A worked example—the life of a custom sofa

Let's walk through a realistic timeline for a custom sectional. It shows how a "16-week lead time" can easily stretch into a much longer wait.

Imagine you're specifying a 12-foot sectional from a good workroom—let's call them Artisan Upholstery Co.

  • Vendor's Quoted Lead Time: 14-16 weeks. But it's from receipt of deposit, approved shop drawings, and all COM/COL materials.

This is the key phrase most clients miss. The clock doesn't start at proposal approval. It starts when the vendor has everything they need to begin.

Here is how the actual project timeline might unfold:

| Stage | Duration | Notes | | :--- | :--- | :--- | | Proposal & Deposit | 1 week | Your client reviews the proposal and pays the initial deposit. | | Shop Drawings | 2 weeks | Artisan Upholstery Co. creates detailed drawings for approval. | | Shop Drawing Approval | 4 days | You review the drawings, send them to the client, and get sign-off. | | COM Fabric Lead Time | 8 weeks | The selected performance velvet is from a Belgian mill with its own queue. | | Fabrication | 15 weeks | The fabric arrives. The sofa enters the production queue and is built. | | Freight | 2 weeks | The finished sofa ships LTL (less-than-truckload) freight to your receiver. | | Receiving & Inspection | 3 days | Your warehouse receives, uncrates, and inspects the piece for damage. | | Total Elapsed Time | ~29 weeks | |

And just like that, the 16-week production time is part of a 7-month total timeline. This isn't an unusual scenario. Walking a client through this math before they approve the proposal is so important. It turns a potential frustration into a moment that builds trust.

Deconstructing the custom journey—key stages

The custom furniture journey has several distinct phases. Each one depends on the one before it.

Client touchpoints—approvals and deposits

The timeline starts with the client. The clock on shop drawings can't start until the deposit is paid. The clock on fabrication can't start until the shop drawings are approved. If a client takes two weeks to approve a drawing that should have taken two days—the whole schedule shifts.

The same goes for COM or COL. The vendor's lead time doesn't begin until that fabric or leather physically arrives at their facility. If your fabric supplier has a 10-week lead time, that's 10 weeks added to the project before the furniture maker even starts.

Beyond fabrication—freight, receiving, and inspection

Once a piece is complete, its journey isn't over. It needs to be crated and shipped. For large items, this usually means LTL freight—which isn't as predictable as a simple FedEx package.

The item then arrives at a receiving warehouse—not your client's home. Here, trained staff uncrate the piece, inspect it for any manufacturing defects or shipping damage, and document its condition. This step is non-negotiable. Finding damage on install day is a catastrophe. Finding it at the receiver is a manageable problem. This inspection takes time and has to be in the schedule.

Building in buffer—expecting the unexpected

Even with perfect planning, delays happen. A key person at the workroom might get sick. A machine could break down. A winter storm could halt all freight for a week.

This is why most senior designers I know add a buffer to the vendor's quoted timeline. For a standard custom piece, adding 2-4 weeks is a safe bet. For something highly complex or sourced internationally, you might add even more. This isn't about misleading the client. It's about building in a realistic cushion for the known unknowns of custom work. It lets you under-promise and—hopefully—over-deliver.

Your single source of truth for custom timelines

Tracking all these moving parts is a lot of administrative work. You have the deposit date in QuickBooks, the shop drawing PDF in a Dropbox folder, the client's approval in a Gmail thread, and the COM lead time in a spreadsheet. It's your job to connect all those spokes.

This is where a central system is essential for your sanity and your firm's reputation. Alcove lets you attach every one of these details—lead times, deposits, shop drawing approvals, COM status, and freight updates—directly to the item in your project. Instead of digging through five different places for the status of one sofa, you and your team have one clear picture.

Keeping track of a dozen custom pieces, each with its own timeline, is a huge part of the job. We built our system to make that part less about chasing details and more about clear communication. So you can spend more time on design decisions and less on hunting for updates.

Price with clarity. Install with confidence.

Learn more at alcove.co.

Daylit contemporary interior with warm wood details

FAQs

How much buffer time should I realistically add to custom furniture timelines?

For most custom pieces, I add 2-4 weeks to the vendor's quoted lead time. This accounts for small production hiccups, freight delays, or inspection issues. For highly complex pieces or those with rare materials, you might consider a longer buffer. It’s always better to under-promise and over-deliver.

What are the most common reasons for custom furniture delays?

From what I've seen, the most common delays come from client approvals—for initial designs, fabric selections, or shop drawings. Issues with COM/COL delivery are a close second. Production queues can also get backed up, especially for popular vendors or during busy seasons. And freight and receiving always add another layer of uncertainty.

How can I communicate potential timeline changes to clients effectively?

Be transparent and proactive. As soon as you see a delay coming, tell your client. Give them a clear explanation and a revised timeline. Skip the jargon and just explain the impact. Having all your project updates in one place, like Alcove, makes it much easier to share accurate information and keep your client's trust.

Is it possible to get real-time tracking for custom furniture orders?

Some freight carriers offer real-time tracking once an item ships. But getting minute-by-minute updates from a workroom during production is rare. Most vendors just provide milestone updates. A system that gathers vendor emails and lets you update the status—like Alcove does—helps you keep the most current picture for your team and clients. It's not 'real-time' like a pizza tracker, but it's the closest we get in this business.
